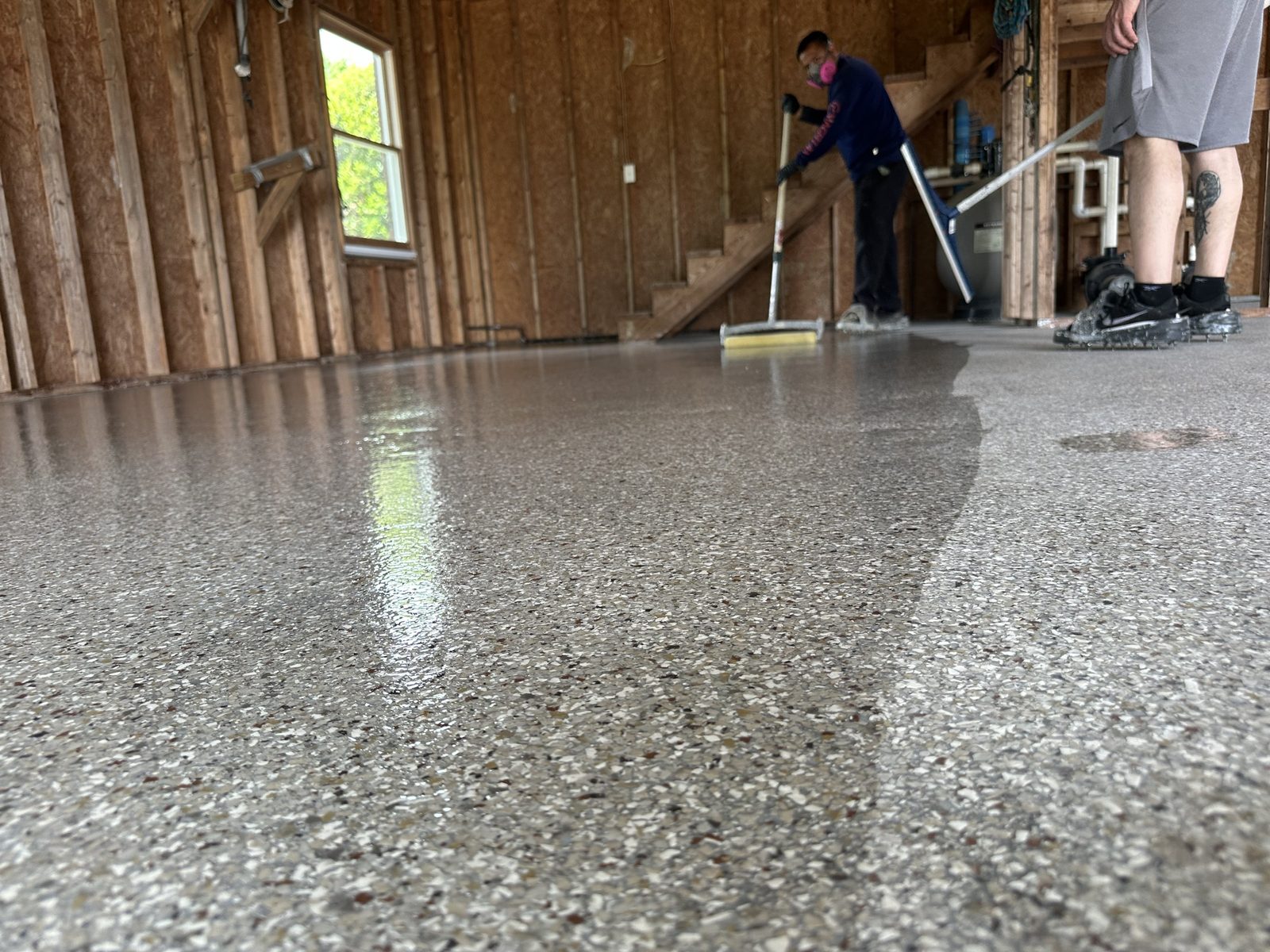

Wet polyaspartic topcoat going down, low angle

How we install

Six steps.
No shortcuts.

Every floor runs the same sequence — first moisture reading to final walkthrough. Most installs take one to two days.

Diamond grinding · Crack & stem wall repair · Full flake broadcast · Polyaspartic topcoat

Polyaspartic topcoat going down

The six steps

From bare slab to finished floor

The sequence never changes. What changes is the system we put down — decided by the moisture readings and the condition of your slab.

Moisture reading on a bare slab1

Inspect & measure

We take moisture readings on the bare slab, check concrete condition, cracks and stem walls, and measure square footage. That is what decides the system — and whether a vapor barrier goes underneath it.

Diamond grinding a garage floor2

Diamond grind

Diamond grinding opens the surface so the coating bonds into the concrete instead of sitting on top of it. Dust is vacuumed at the machine as we go.

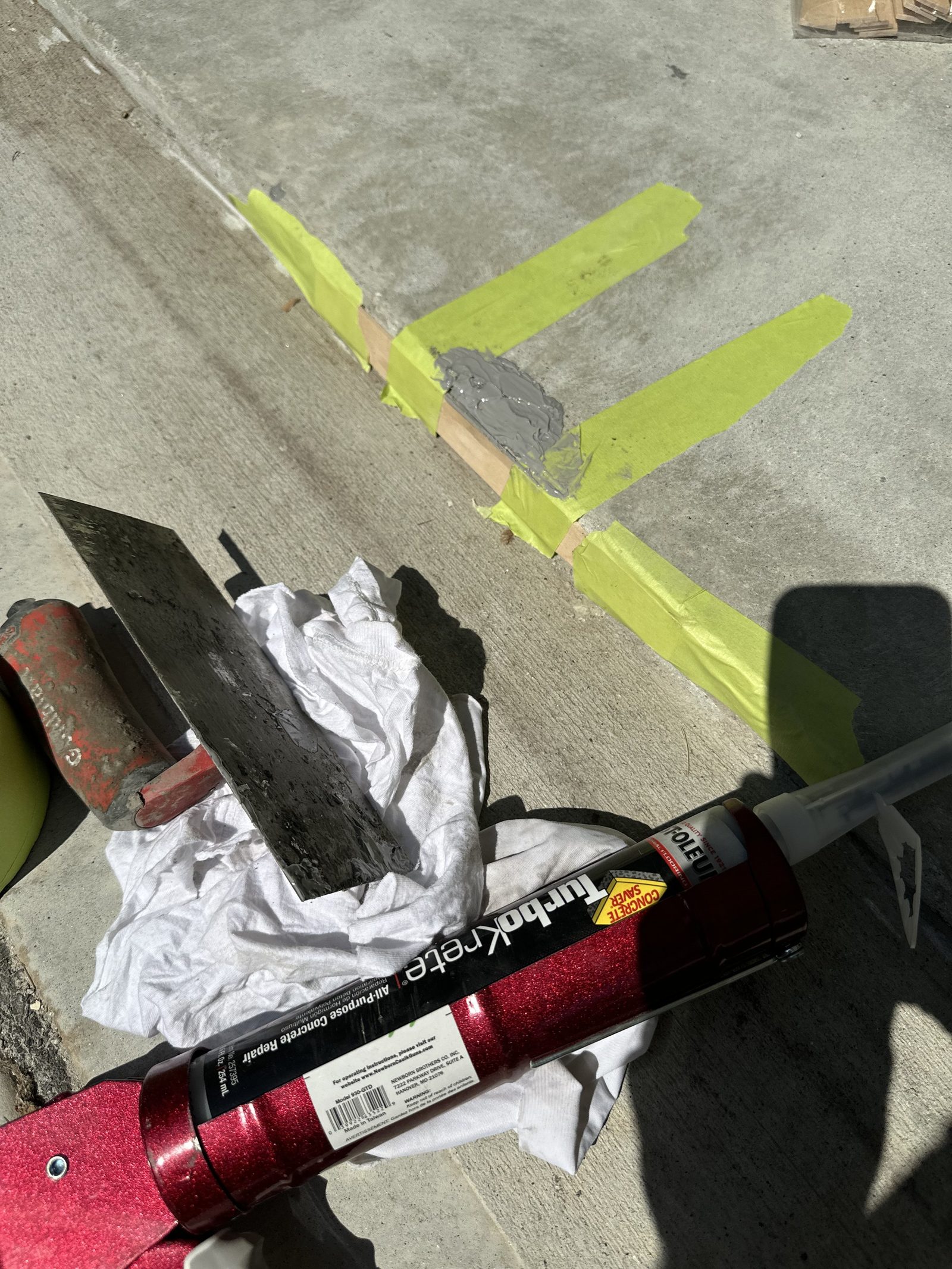

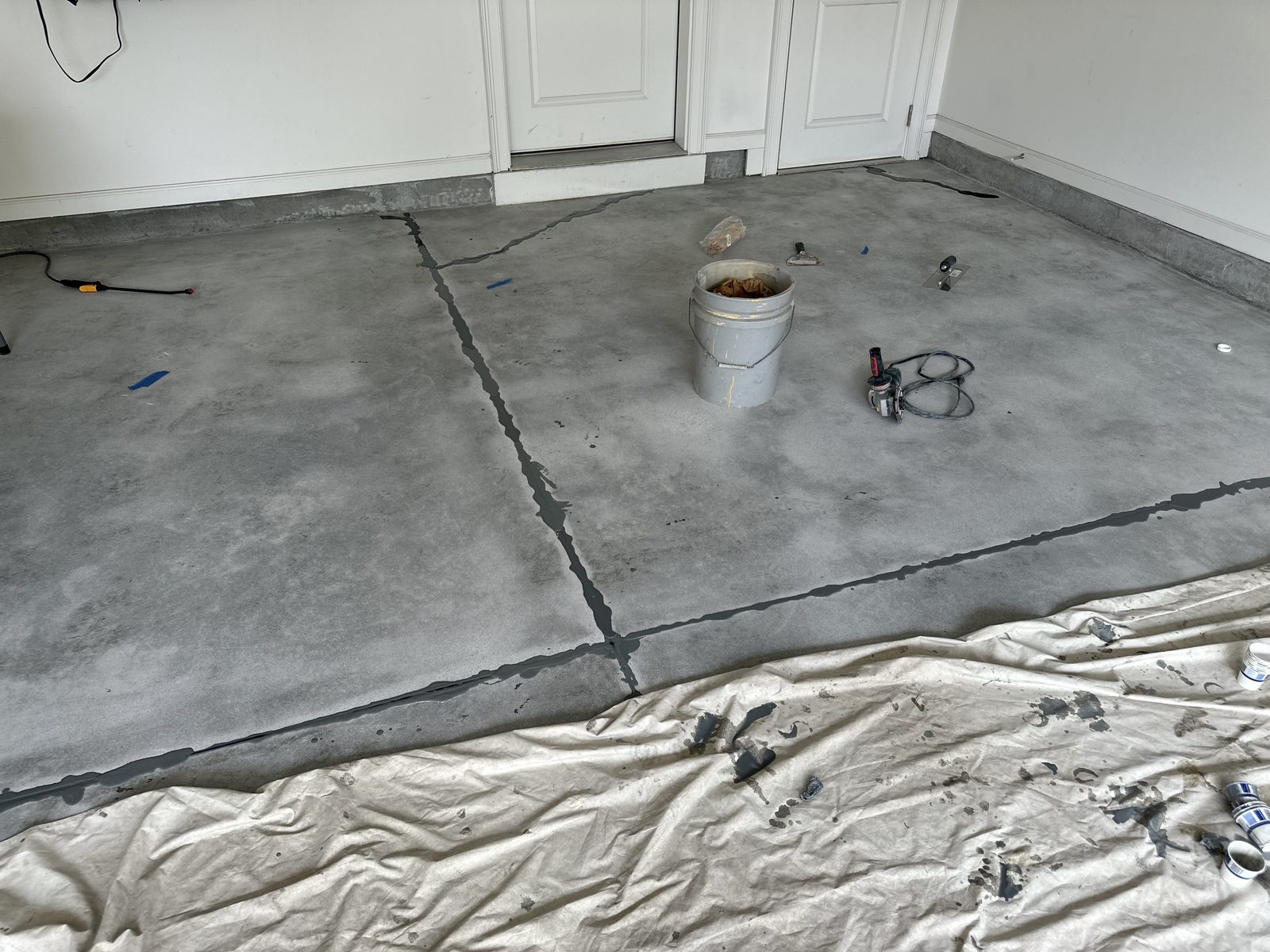

Garage slab with the cracks and joints filled, ready for coating3

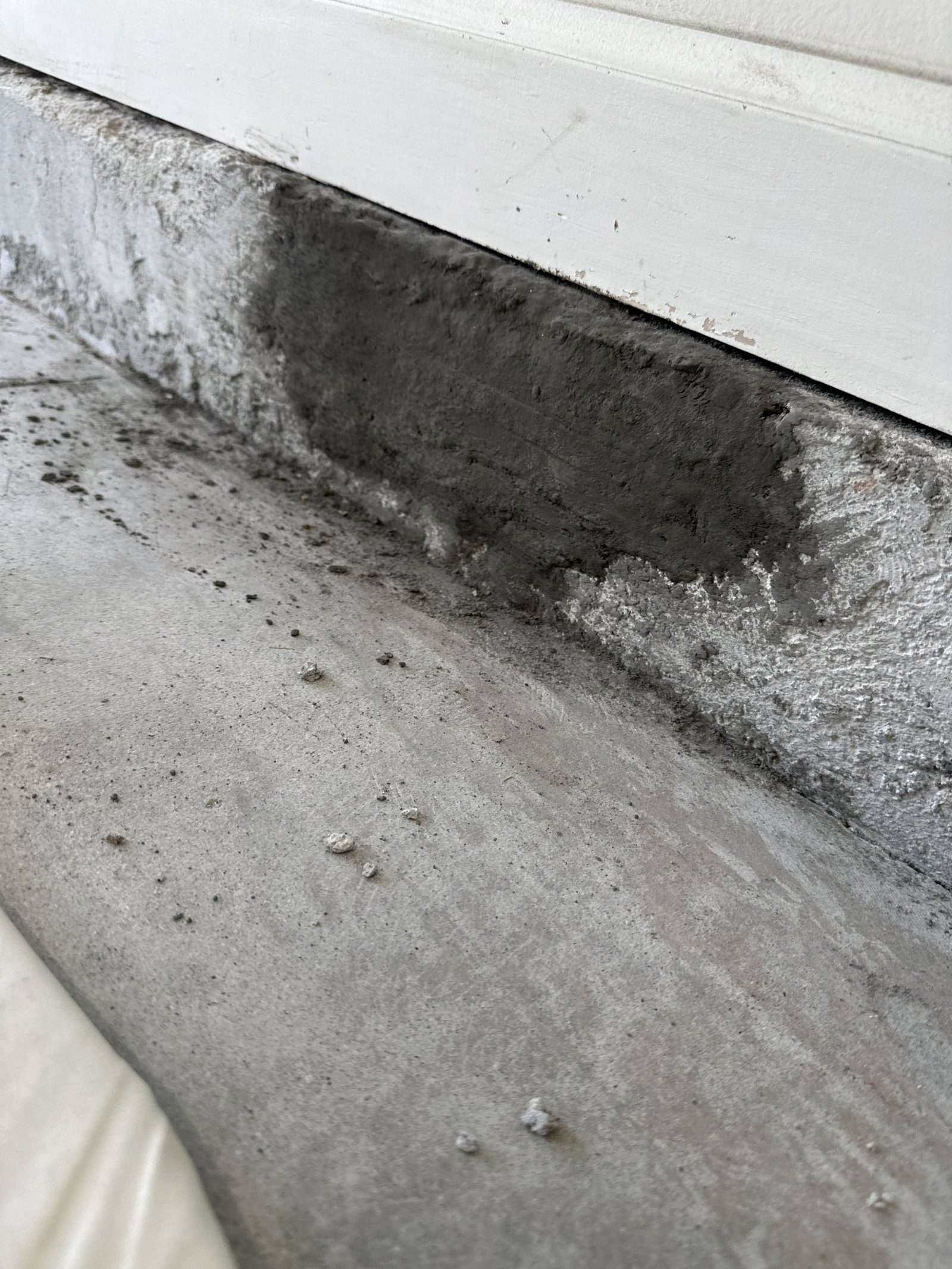

Stem wall patched
Stem wall patched
Joint filled
Joint filled

Repair cracks & stem walls

Cracks, control joints and crumbling stem walls get filled and rebuilt before any coating goes down. Skipping this is why coatings fail at the edges first.

Vapor barrier being rolled onto a ground garage slab4

Base coat

When the moisture readings call for it, a vapor barrier goes down first — that is what is being rolled here. Then the epoxy or polyurea base goes down wet and bonds into the ground concrete.

Flake broadcast over the wet base5

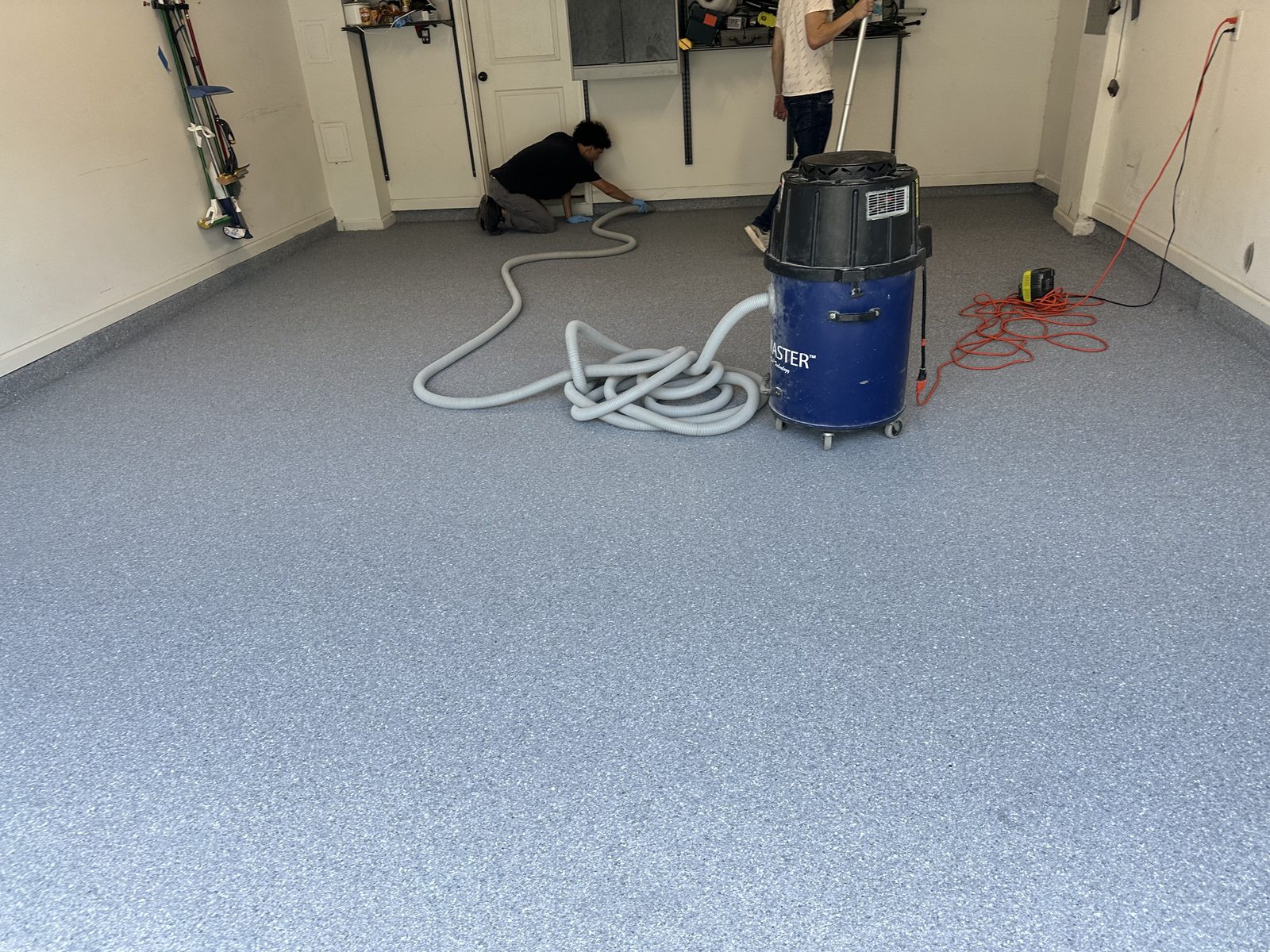

Scrape and vacuum
Scrape and vacuum

Full flake broadcast

Flake is broadcast to refusal across the wet base, then scraped and vacuumed once it cures so the surface comes back flat and even underfoot.

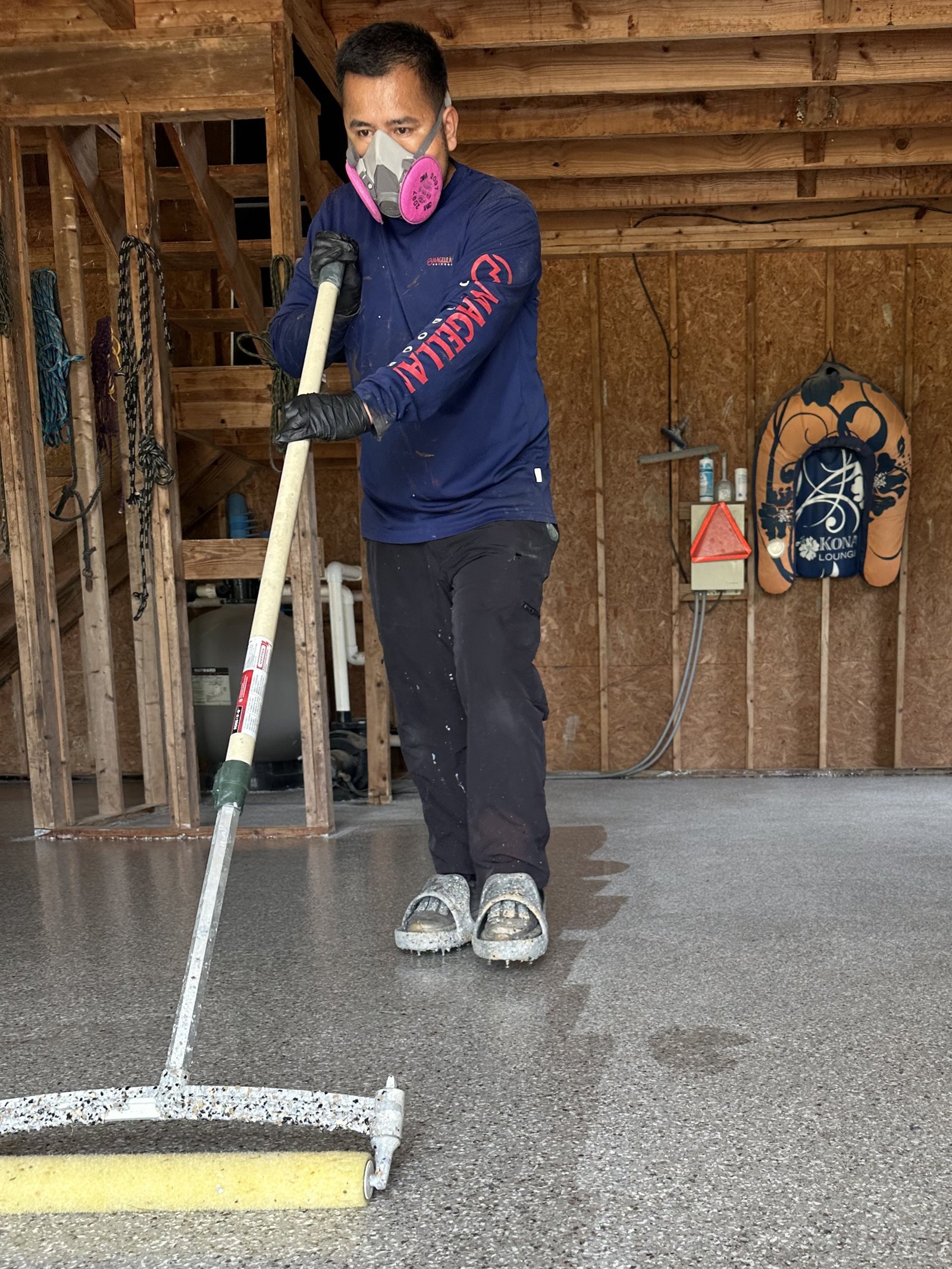

Installer squeegeeing the polyaspartic topcoat across a barn floor6

Polyaspartic topcoat & walkthrough

A clear polyaspartic topcoat locks in the flake and takes the UV, chemicals and traffic. Then we walk the finished floor with you before we leave.

Day of install

Most installs are one to two days.

Here is how a typical two-car garage runs. Larger barns, shops and commercial floors spread across more days. Timing varies with the size of the space, concrete condition and weather — we confirm the schedule on site.

  1. StartArrive, protect walls and mask off
  2. ThenDiamond grind the slab
  3. NextCracks, joints and stem walls
  4. After thatBase coat goes down
  5. ThenFull flake broadcast
  6. Late in the dayScrape and vacuum
  7. Before we leaveTopcoat and walkthrough
Walk on it in 4 hoursDrive on it in 24 hoursWe haul off the debris

Before we arrive

What we need from you

01

Clear the floor

Everything off the slab — cars, shelving, fridges and storage. Tell us ahead if you need a hand with the heavy things.

02

Nothing to plug in

Our grinders and vacuums run off our own power. You do not need to supply an outlet or a water spigot.

03

Keep the space closed off

Pets and kids out of the area during the install and overnight while the topcoat cures.

We travel for larger jobs.

Same garage · same camera position

Start to finish

One Atlanta garage, photographed from the same spot at four points in the install.

Bare slab before
1 · Before
Oil-stained bare slab
Ground slab
2 · Ground
Diamond ground and repaired
Base coat
3 · Base coat
Wet base going down

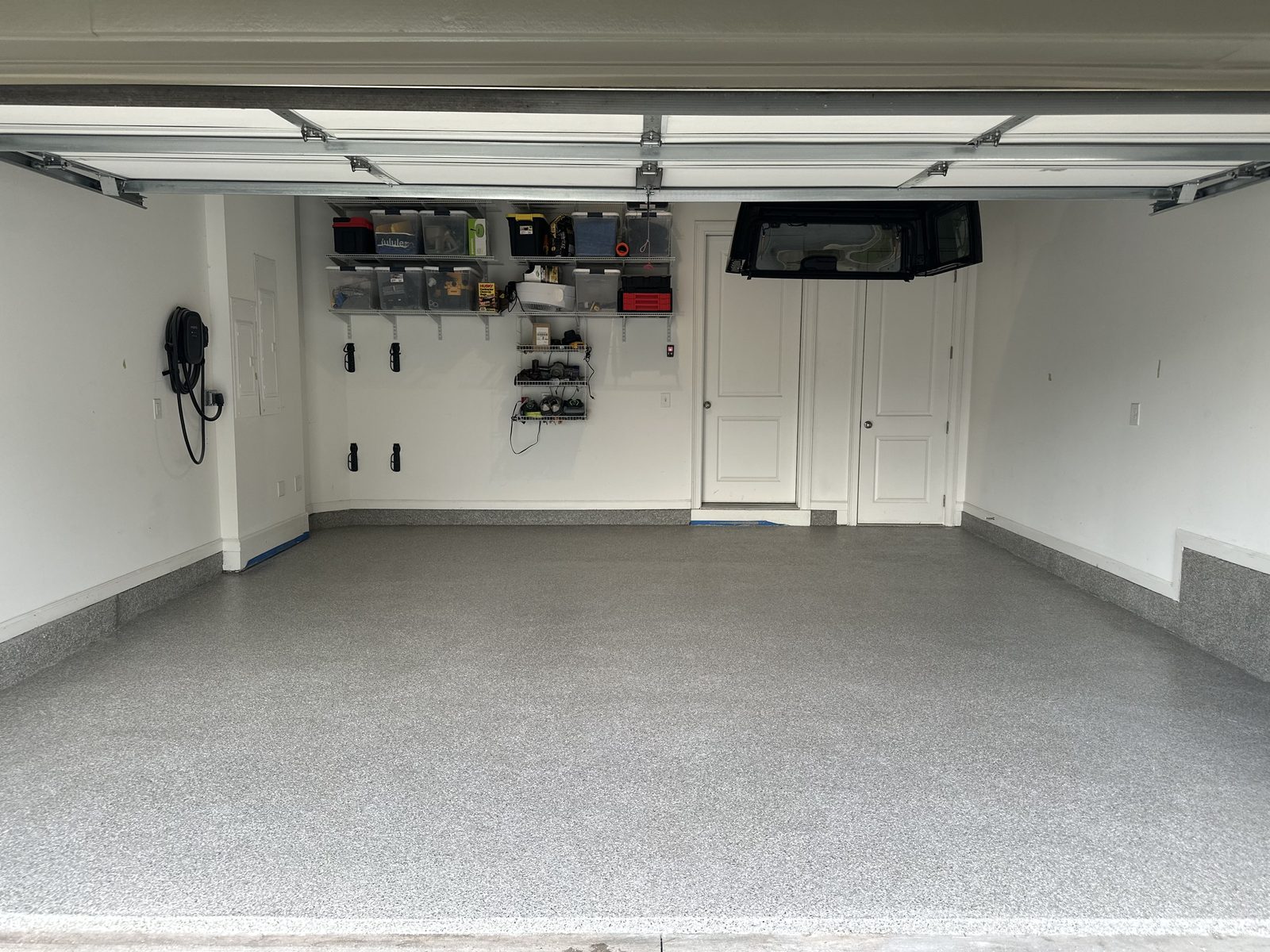

Finished floor
4 · Finished
Full flake and topcoat

Roswell garage · same camera position through the install.
